NYC Renovation Questions Everyone Asks (Answered by Experts)

The questions Gallery KBNY gets asked most about renovating in NYC, answered the way we'd answer in person

June 26, 2026

|

8
mins to read
NYC Renovation Questions Everyone Asks (Answered by Experts) — Gallery KBNY

NYC Renovation Questions Everyone Asks (Answered by Experts)

The questions Gallery KBNY hears most from NYC homeowners, answered in depth. From design-build to board approvals, costs, timelines, and what actually causes delays.

Table of contents

Renovating in New York City raises a specific set of questions that have no equivalent elsewhere. Board approvals, DOB filings, alteration agreements, wet-over-dry restrictions, co-op board discretion on scope, pre-war mechanical constraints. These are realities that prospective renovators in Manhattan and Brooklyn encounter at virtually every stage of a project. The questions below are the ones Gallery KBNY fields most consistently, addressed with the directness we use in client conversations.

These complexities are why renovation planning in NYC tends to raise so many questions, particularly around feasibility, timelines, budgets, and process. Without informed guidance, it can be difficult to distinguish between what is technically achievable, what is permitted by a specific building, and what is realistic within a given timeframe or budget.

About Gallery KBNY

Gallery KBNY is an award-winning, full-service design-build firm specializing in the architecture, interior design, and renovation of apartments, co-ops, condominiums, townhomes, and lofts across Manhattan and Brooklyn. Our integrated team of architects, designers, contractors, and project managers — with a founding partner involved in every project — manages every phase from board approvals and DOB permitting through design and construction. Because architecture, design, permitting, and construction are coordinated under one roof, the process remains streamlined, accountable, and transparent from start to finish. Our work has been recognized by Forbes, The New York Times, Architectural Digest, and Inc., and we have received Houzz Best of Design & Service seven consecutive years, along with 100+ five-star client reviews.

At Gallery KBNY, we believe successful renovations begin with clarity and informed decision-making. The questions below reflect the most common topics that arise when planning apartment and townhouse renovations in New York City. Hopefully they can provide practical context and help set accurate expectations before your project begins, so the process can be approached thoughtfully as possible, with fewer surprises and more predictable outcomes.

[#1]Common Questions About Renovation Approach[#1]

Powder room from our West Village condo gut renovation at 17 Cornelia St.

What Is The Most Effective Way To Renovate An Apartment Or Townhouse In NYC?

A full-service design-build model, integrating architecture, interior design, permitting, and construction under one contract, produces the most predictable outcomes in New York City. Board approvals, DOB filings, building logistics, and material procurement all require active coordination between design decisions and construction realities. When those functions are managed by a single integrated team, potential conflicts between design intent and buildability are identified before they become schedule or cost problems. When they are split across separate firms, coordination gaps are common and tend to surface at the worst possible moment: during construction.

How Does A Design-Build Firm Differ From Hiring A Separate Architect And General Contractor

A design-build firm provides architectural services, interior design, permitting support, and construction management under one contract and one fee. In the traditional model, an architect produces completed drawings before a contractor is engaged; when the contractor prices those drawings, budget revisions and redesigns often follow. Design-build eliminates that gap by having the builder involved during design, so cost and schedule implications of design decisions are evaluated in real time rather than discovered after drawings are complete. For renovations in NYC co-ops and condos, where board submissions require coordinated documentation from design and construction teams, a single-firm structure reduces the administrative overhead of assembling those packages.

Dining room from our Manhattan co-op renovation in Sutton Place at 245 E 54th St.

Are Design-Build Firms Well-Suited For High-End Renovations?

Yes. The design-build model is well-established in high-end residential renovation because integration produces greater control over quality, finish standards, and budget management. Gallery KBNY has been recognized by Forbes, The New York Times, Architectural Digest, and Inc. for its work in luxury residential renovation in New York City, and has received 7x Houzz Best of Design. The firm's design-build structure is a direct contributor to the quality and consistency of outcomes across that work.

Kitchen from our Sutton Place co-op renovation in The Sovereign at 425 East 58th Street.

[#2]Common Questions About Choosing A Renovation Firm [#2]

What Experience Should I Look For In A NYC Renovation Firm?

Domain expertise in your specific property type is the single most important factor. A firm renovating a pre-war co-op on the Upper East Side needs working knowledge of that building's alteration agreement requirements, the co-op board's submission standards, the electrical and plumbing constraints typical of that building stock, and the neighborhood's specific permitting environment. General renovation experience does not substitute for that specificity. Beyond property type, the practical indicators of a strong firm are: detailed pre-construction planning documented in writing, clearly itemized estimates with realistic allowances, transparency about how change orders are handled, and a track record of completing comparable projects on schedule and within budget.

What Are The Specific Challenges Of Renovating In Co-Ops And Condominiums Compared To Other Property Types?

Co-op and condominium renovations in New York City require a level of compliance and coordination that single-family renovation does not. Before construction begins, most buildings require a formal board approval, a comprehensive submission package including architectural and engineering drawings, and contractor insurance and indemnification documentation meeting the building's specific standards. During construction, renovation teams must coordinate work-hour restrictions, elevator scheduling, noise mitigation, debris removal protocols, and material delivery access with building management. Many buildings also impose technical standards on plumbing, electrical, and waterproofing work that go beyond what the DOB requires. Firms without substantial co-op and condo renovation experience regularly underestimate this compliance burden, which translates directly into timeline extensions and budget surprises.

Bathroom from our Tribeca loft condo renovation at 345 Greenwich Street.

How Do I Evaluate Whether A Renovation Firm Is Reputable In New York City?

Reputation in New York City residential renovation is best evaluated through specific evidence rather than general claims. Look for demonstrated experience with your building type and neighborhood, and the ability to articulate how the firm navigates board approvals, DOB filings, and building-specific technical constraints. Request itemized proposals from comparable projects with clearly defined scope, realistic allowances, and a stated change-order policy. Strong firms can provide references from clients in buildings similar to yours. Firms that avoid discussing building-specific constraints, produce estimates without a site visit, or price work based on broad assumptions rather than your actual building's requirements are transferring risk to the client in ways that reliably surface as change orders and delays.

[#3]Common Questions About The Renovation Process [#3]

Are You Limited To Certain Material Selections Or Brands When You Work With Design Build Firms?

This varies by firm. Some design-build companies require selections from an in-house showroom or preferred vendor network, which limits options and may affect pricing. Gallery KBNY is fully brand-agnostic and vendor-neutral, sourcing materials from any supplier that meets the project's specification and quality standards. Trade pricing discounts are passed through to clients without markup.

Can I Renovate A New York City Apartment If I Am Remote Or Live Outside The City?

Yes, and Gallery KBNY handles a significant number of renovations for clients who are not in New York during construction, including second-home and pied-a-terre owners who may be present only periodically. The key requirement for a successful remote renovation is front-loading the design decision process: all major selections, layout decisions, and material specifications confirmed before construction begins so the project does not depend on on-site client availability to resolve questions. Gallery manages the full process through a secure project management platform that provides clients real-time access to schedules, selections, progress photos, change orders, and documentation regardless of location.

Kitchen from our Upper West Side condo renovation at 151 W 74th St.

Who Is Responsible For Permits And DOB Filings During A Renovation?

Permits and Department of Buildings filings are managed by the architect or design-build team overseeing the project, supported by a licensed expediter for filings that require one. At Gallery KBNY, this is handled by the firm's in-house architects and expediting relationships, covering the full sequence from initial filing through final inspection sign-off.

How Do Renovation Teams Coordinate With Building Management And Supers?

Experienced renovation teams establish direct working relationships with managing agents, resident managers, and superintendents at the start of every project. This coordination covers elevator scheduling, building access protocols, required floor and wall protections in common areas, noise and work-hour compliance, and material delivery logistics. At Gallery KBNY, this is managed by a dedicated project coordinator who maintains ongoing communication with building staff throughout construction.

Kitchen from our Greenpoint condo renovation at 21 India Street.

What Is The Typical Renovation Process In NYC?

A full NYC apartment renovation proceeds in two distinct phases. The first covers planning and approvals: feasibility review, design development, construction documentation, board submission, DOB permitting, and procurement of long-lead materials. This phase typically runs four to six months for a full renovation in a co-op or condo. The second phase is construction, covering demolition, rough mechanical work, enclosure, finishes, millwork installation, and close-out inspections. Construction typically runs three to six months depending on scope. The total project duration for a full gut renovation in Manhattan generally falls in the eight-to-twelve-month range.

Will There Be A Dedicated Project Manager During Construction?

Yes. At Gallery KBNY, every project is assigned a dedicated project manager who oversees scheduling, trade coordination, quality control, and client communication from start through close-out. For larger-scale renovations, an on-site supervisor is also assigned for daily site oversight. A partner of the firm is directly involved and communicates with clients throughout the project, which provides an additional layer of accountability that larger firms typically cannot offer.

How Is Communication Typically Handled During A Renovation?

Communication at Gallery KBNY is centralized through a secure project management platform that clients have full access to, where schedules, selections, documents, change orders, invoices, progress photos, and all project messaging are maintained in one place. A dedicated project manager and project coordinator serve as primary points of contact throughout the renovation. Clients receive regular structured updates and have direct access to project leadership when decisions are needed. For remote clients, this structure is particularly valuable because every decision and update is documented in writing, eliminating the miscommunications that arise when information is passed verbally across a distributed team.

How Involved Do I Need To Be During A Renovation Of An Apartment In NYC?

When working with a full-service design-build firm, client involvement is concentrated in the design and selection phase rather than distributed across the full construction period. Gallery KBNY manages building submissions, permitting, trade coordination, and day-to-day site oversight independently, so clients are not required to manage those details directly. Some clients prefer a more hands-on role in design decisions and check-ins; others prefer to review options and delegate detail management entirely. Both approaches are accommodated. The commitment required during construction is primarily limited to timely responses on decisions that affect the schedule.

Kitchen render to reality from our co-op loft renovation in Tribeca at 335 Greenwich St.

Will I See Drawings Or Renderings Before Construction Begins?

Yes, as a full service design and build firm, all of our projects have full set construction and design drawings. This includes technical drawings, elevations, reflective ceiling and electrical plans, and photo realistic 3D renderings.

[#4]Common Questions About NYC Renovation Costs And Budget Management[#4]

Living room from our Upper West Side pre-war co-op renovation at 801 West End Ave.

What Happens If Unexpected Issues Are Found After Demolition?

Gallery's pre-construction process is specifically designed to surface potential conditions before demolition begins rather than after. This includes evaluating electrical capacity, testing for lead and asbestos, assessing plumbing and structural constraints, and reviewing all building-specific rules governing the scope. At Gallery, change orders and cost overruns average less than 2% of the total project budget across all projects, with the majority of projects completing at zero overrun excluding client-initiated scope changes. When a genuinely unforeseen condition does arise, it is evaluated immediately and presented to the client with clear cost and schedule implications. No additional work proceeds without written approval.

Considering a Renovation in NYC?

Click to schedule a consultation with one of the principle partners at Gallery, who will hear out your renovation plans and let you know the best way to proceed - whether we end up working together or not.

Schedule Your Consultation

How Much Does A Full Apartment Renovation In NYC Typically Cost?

Renovation costs in New York City depend heavily on building type, existing conditions, finish level, and scope. For a full gut renovation of an 1,800-square-foot pre-war apartment in estate condition with upper mid-tier finishes and full HVAC work, the typical range is $500 to $650 per square foot, or approximately $850,000 to $1,000,000 or more, inclusive of design, architecture, permits, labor, and all specified finishes. Upgrading to luxury or bespoke finishes with elaborate millwork and full window replacement shifts that range to $700 per square foot and above. A full renovation of a comparable apartment in a newer building in generally good condition, with primarily cosmetic scope, typically runs $375 to $500 per square foot. Brownstones and townhouses typically start at $600 per square foot for a full interior gut, with landmarked properties adding a meaningful premium.

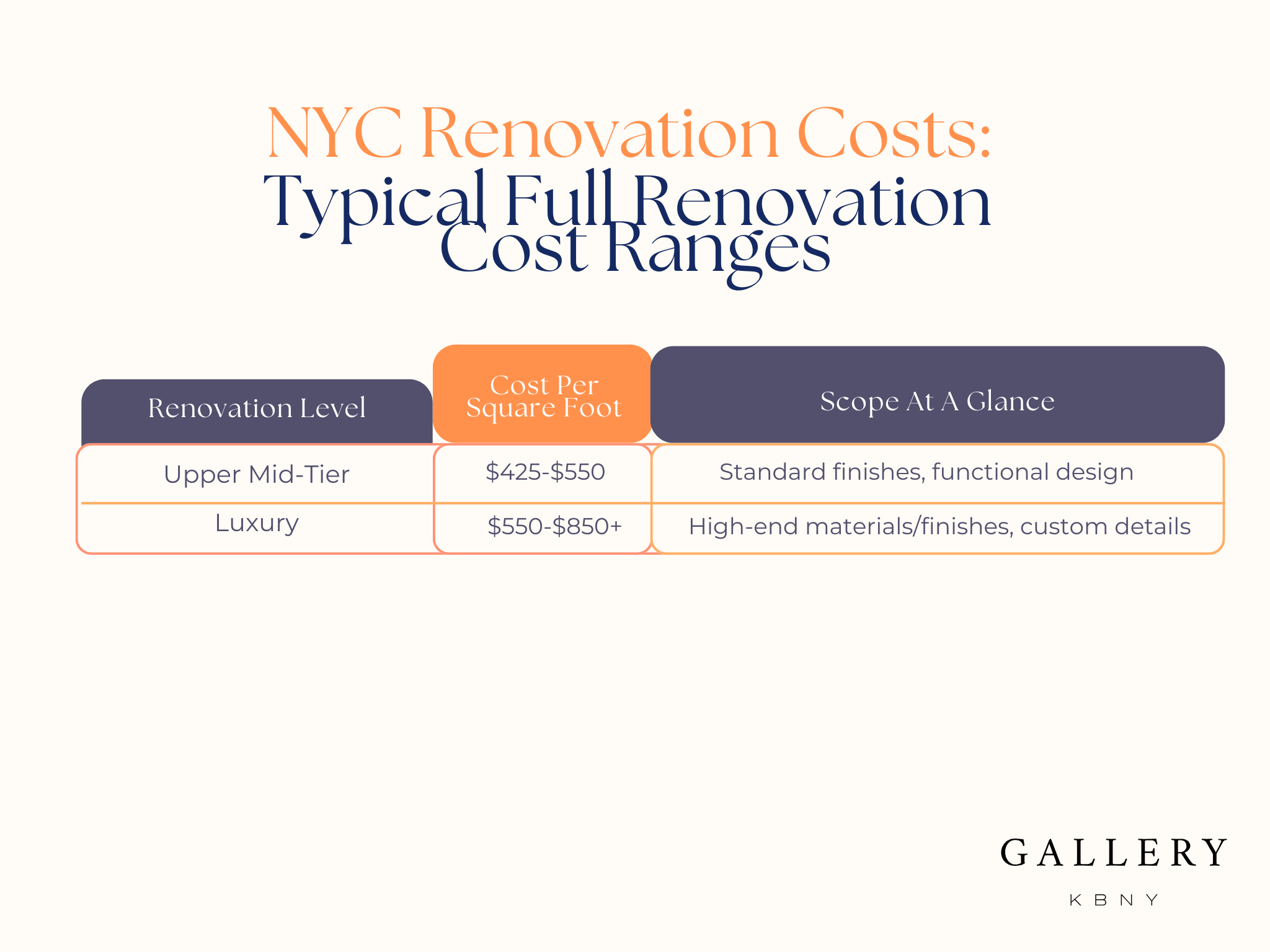

NYC Renovation Cost by Property Type and Scope
NYC Renovation Costs · 2026
Cost Per Square Foot by Property Type and Finish Tier
Renovation costs in New York City vary significantly based on building type, existing conditions, and finish level. The ranges below reflect full-scope renovations in Manhattan and Brooklyn at Gallery KBNY's service tier, inclusive of design, architecture, permits, labor, and finishes. They do not include furniture or appliances unless noted.
Upper Mid
Upper Mid-Tier
Luxury
Luxury
Ultra
Ultra-Luxury / Bespoke
Post-War & Newer Construction · Generally Good Condition
Full Apartment Cosmetic to moderate scope; no major MEP changes $375–$500 /sqft
$500–$650 /sqft
$650–$800+ /sqft
Pre-War Apartments · Manhattan · Older Infrastructure
Full Gut Renovation Includes HVAC, plumbing, electrical updates $500–$650 /sqft
$600–$850 /sqft
$850+ /sqft
Estate Condition Deferred maintenance; full systems replacement $550–$700 /sqft
$700–$900 /sqft
$900–$1,200+ /sqft
Brownstone & Townhouse · Brooklyn & Manhattan
Full Interior Gut Multi-level; structural, MEP, interiors $600–$750 /sqft
Landmarked: add 10–20%
$750–$900 /sqft
Landmarked: add 10–20%
$900–$1,400+ /sqft

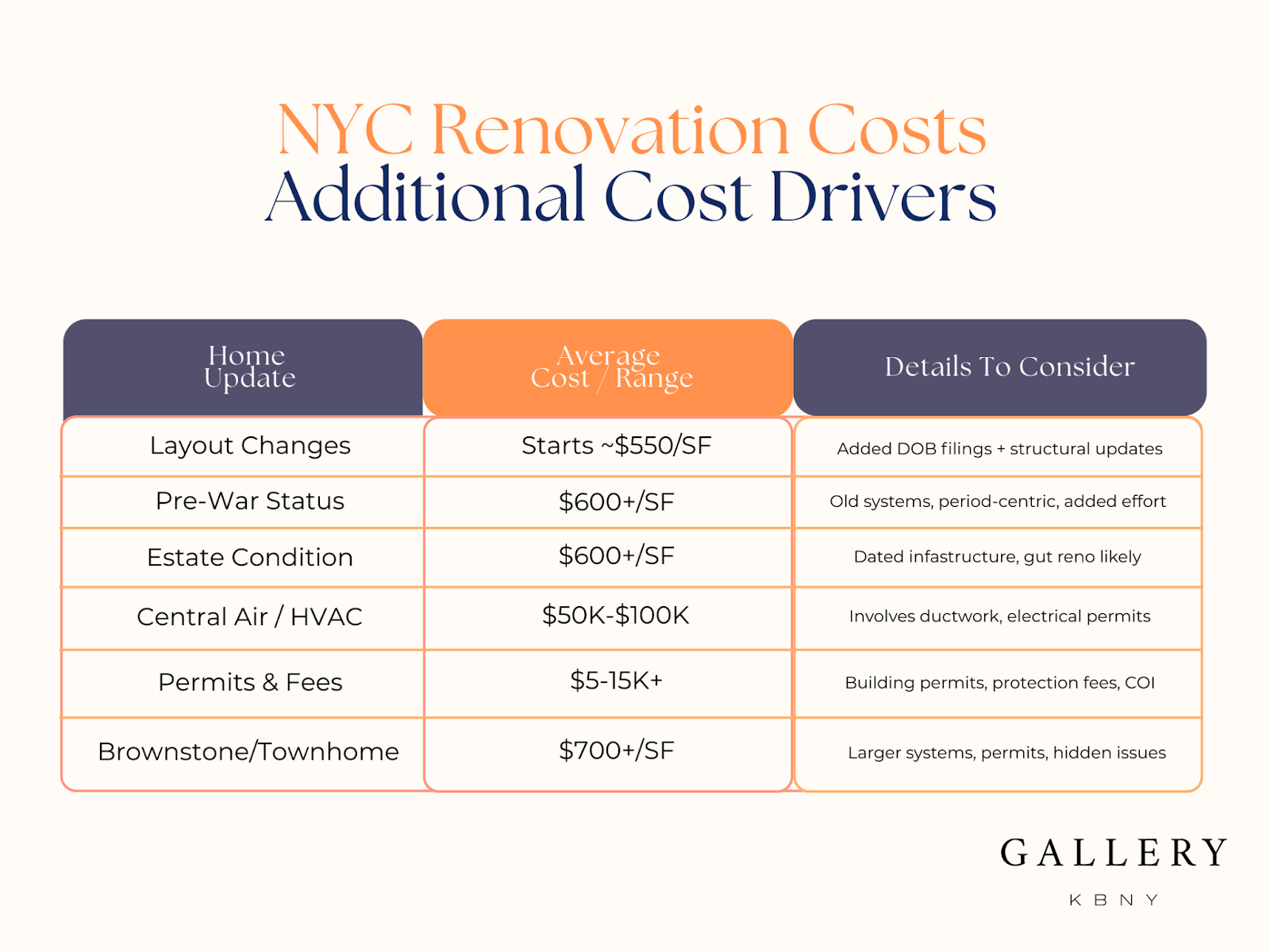

Common Scope Modifiers · Applied on Top of Base Range
Layout Changes Wall removal, plumbing relocation, open plan Layout modifications add $30–$80/sqft to affected areas; load-bearing walls require structural engineering review and add cost above that range. Plumbing relocations in pre-war buildings typically run $15,000–$45,000 per wet location moved.
Apartment Combination Two units merged into one Combinations require co-op or condo board approval, DOB filings for the structural opening, and full MEP redesign across both units. Base renovation cost applies to the combined square footage; structural and approval costs are additive.
Example: A full gut renovation of an 1,800 sqft pre-war Manhattan apartment in estate condition with upper mid-tier finishes and HVAC work typically totals $850,000–$1,100,000+ inclusive of design, architecture, permits, labor, and finishes.

To better understand renovation pricing in 2026, start with our cost-per-square-foot analysis, then review our planning guide for budgeting insights and strategic considerations.

How Can I Tell If A Renovation Estimate Is Transparent?

A transparent estimate is specific to your building and unit, not a generalized template. It defines scope line by line, states what is excluded, and provides realistic material allowances matched to the finish level described in the brief. In New York City specifically, a complete estimate accounts for board submission costs, expediter fees, DOB filing costs, and building-specific insurance and compliance requirements. Estimates that carry artificially low allowances to produce a competitive total, that are produced without a site visit, or that use vague language around inclusions are transferring financial risk to the client in ways that reliably surface as change orders during construction.

  • Read our full guide to evaluating NYC renovation estimates here.

What Makes Gallery KBNY Different From Other NYC Design Build Firms?

Gallery KBNY focuses exclusively on co-ops, condominiums, and pre-war apartments in Manhattan and Brooklyn. The firm's process is built around upfront due diligence: evaluating electrical capacity, plumbing constraints, HVAC feasibility, logistics, and regulatory requirements before construction begins. Architecture, interior design, project management, and construction operate under one coordinated team, with a firm partner directly involved in every project from start to completion. Gallery has been recognized by Forbes, The New York Times, Architectural Digest, and Inc., and has received 7x Houzz Best of Design.

Ensuite bathroom from our Manhattan loft renovation at 9 Murray St.

How Are Change Orders Handled During Renovations?

Change orders at Gallery KBNY fall into two categories. Client-initiated changes occur when the owner modifies the agreed scope: upgrading a finish, adjusting a layout, or adding new work. These are documented in writing with a clear description of the revised scope, the cost impact, any credit for removed work, and the schedule effect. No additional work proceeds without written approval. Contractor-initiated change orders arise when unforeseen conditions require work beyond the contracted scope. On well-planned projects, these are uncommon. Gallery's pre-construction diligence is specifically structured to minimize them. When they do occur, the same documentation and approval process applies.

  • Read our full guide to change orders in NYC renovations here.

How Can Budget Overruns Be Prevented In NYC Renovations?

Budget overruns are primarily a pre-construction problem. The conditions that produce overruns are almost always present before demolition begins: scope that is not precisely defined, material allowances that do not reflect actual selections, building constraints that have not been assessed, and a change-order process that lacks written controls. Gallery's approach addresses all four: scope is defined in detail before contract signing, allowances are calibrated to confirmed selections, building constraints are assessed during pre-construction, and all change orders require written documentation and approval before work proceeds. During construction, long-lead materials are ordered early, key selections are locked before they affect the schedule, and the project management team maintains active oversight of the budget against the contracted scope.

[#5]Common Questions About NYC Renovation Timelines[#5]

How Long Does A Typical NYC Apartment Renovation Take?

A full gut renovation of an apartment in a Manhattan co-op or condo typically runs eight to twelve months from the initial client conversation to move-in. That duration is divided between a planning and approvals phase, which typically takes four to six months, and a construction phase, which typically runs three to six months depending on scope. Cosmetic renovations in newer-construction condos can be completed more quickly; complex pre-war gut renovations or apartment combinations requiring board approval for structural changes may run beyond twelve months. Owners planning a renovation should begin the process five to six months before their target construction start date to allow adequate time for design development, board submission, and permitting.

What Affects The Timeline Most Significantly?

The most significant timeline drivers in a New York City renovation are scope complexity, building approval requirements, procurement of long-lead materials, and the completeness of design decisions at the start of construction. Full mechanical replacements, layout changes, and apartment combinations add more time than cosmetic work. Co-op board approvals and DOB permitting add pre-construction time that cannot be compressed. Custom millwork, stone, windows, and specialty fixtures have lead times of eight to sixteen weeks and must be ordered during the planning phase to avoid construction delays. Late design decisions or scope changes during construction are among the most consistent causes of timeline extension in otherwise well-managed projects. Read our full guide to NYC renovation timelines here.

NYC Renovation Timeline by Phase
NYC Renovation Planning
Realistic Timeline: From First Conversation to Move-In
A full NYC apartment renovation runs in two distinct phases — planning and approvals, then construction. The durations below reflect typical co-op and condo renovations in Manhattan and Brooklyn. Complex scopes, pre-war buildings, or late design decisions extend these ranges.
Phase 1 Planning & Approvals Typically 4–6 months
Initial Consultation & Feasibility Scope definition, building constraints review, pre-purchase assessment if applicable
2–4 wks
Design Development Floor plans, interior design direction, material selections, renderings
4–8 wks
Construction Documentation Technical drawings, elevations, electrical and ceiling plans, engineering coordination
3–6 wks
Board Submission & Approval Alteration agreement, managing agent review, board sign-off; co-ops require more time than condos
4–8 wks
DOB Permitting Filing, expediter coordination, permit issuance; can run parallel with board review in condos
2–6 wks
Long-Lead Procurement Custom cabinetry, stone, windows, specialty fixtures ordered during approval phase
8–16 wks
Phase 2 Construction Typically 3–6 months
Demolition & Pre-Construction Selective or full gut demo; lead and asbestos testing and remediation if required
1–3 wks
Rough Work (MEP) Structural, plumbing, electrical, HVAC rough-in; inspections at each phase
4–8 wks
Plaster, Drywall & Flooring Wall enclosure, skim coat, flooring installation; pre-war buildings require extra plaster time
3–5 wks
Millwork & Cabinetry Installation Custom cabinetry, built-ins, kitchen installation; sequenced around long-lead delivery
2–4 wks
Finish Work & Fixtures Tile, stone, plumbing trim, electrical devices, paint; the most time-sensitive sequencing phase
3–5 wks
Inspections, Punch List & Close-Out DOB sign-offs, final walk-through, close-out documentation submitted to managing agent
1–3 wks
Total Project Duration
Full gut renovation, co-op or condo in Manhattan · complex pre-war projects may run longer
8–12 months
Start planning 5–6 months before target construction start
Planning & approvals (~45% of total duration)
Construction (~55% of total duration)

When Should I Start Planning A Renovation In A NYC Co-Op?

Co-op renovation planning should begin at least five to six months before the intended construction start date, and up to twelve months before the target completion date for full gut renovations. The approval and documentation phase in a co-op typically runs four to six months before a shovel goes in the ground: design development, construction documentation, board submission, managing agent review, and DOB permitting all take time that cannot be eliminated through urgency. Owners who initiate the planning process early gain control over their timeline; those who start late typically absorb delays they did not budget for.

  • Read our full guide to NYC co-op renovation timelines here

What Commonly Causes Delays In NYC Renovations?

The most consistent causes of delay in New York City apartment renovations are incomplete pre-construction planning, board and managing agent review timelines, late design decisions during construction, and long-lead material procurement that was not initiated early enough. In co-ops and condos, board review rounds, DOB inspection queues, and building-specific work-hour restrictions all affect the schedule in ways that cannot be managed around. Pre-war buildings add the possibility of unforeseen conditions during demolition, though thorough pre-construction assessment substantially reduces that risk. Projects that invest heavily in pre-construction planning and lock all major design decisions before demolition begins consistently outperform projects where those decisions are deferred.

How Can I Evaluate Whether A Renovation Firm Is Reputable?

Reputation in New York City residential renovation is best evaluated through specific evidence. Look for demonstrated experience with your property type and building category, including the ability to articulate how the firm handles board submissions, DOB filings, and building-specific technical constraints. Request itemized proposals from comparable projects with clearly defined scope, realistic allowances, and an explicit change-order policy. Strong firms can provide references from clients in buildings similar to yours. Firms that avoid discussing the specifics of the approval process, produce estimates without visiting the site, or cannot articulate how they manage change orders are not equipped to manage the realities of renovation in New York City.

How to Evaluate a NYC Renovation Estimate
Evaluating Renovation Firms
What a Transparent NYC Renovation Estimate Looks Like
In New York City, a reliable renovation proposal is specific to your building and unit, not a template. The distinctions below help identify estimates built on real pre-construction diligence versus those that defer risk to the client through vague language and undercosted allowances.
What to look for A Well-Prepared Proposal
Warning signs Proposals That Transfer Risk
What's included Line-item scope with specific deliverables per room: what is being built, replaced, or demolished, and to what specification
Warning sign "Full renovation" or "as per plans" used without itemization; scope defined by a single lump sum with no breakdown
Exclusions stated Explicit list of what is not included — permits, furniture, appliances, utility upgrades — so out-of-scope additions are clear from the outset
Warning sign No exclusions section; client discovers items "aren't included" only after contract is signed
Realistic allowances Material allowances matched to the specified finish level; kitchen tile allowances that actually buy the tile shown in renderings
Warning sign Artificially low allowances used to compress the total number; upgrades to realistic materials trigger large change orders post-contract
Material sourcing explained Clear statement of how materials are priced: trade pricing, markup policy, vendor-agnostic sourcing or in-house showroom
Warning sign No disclosure of markup on materials or required use of an in-house showroom with no outside sourcing option
Approvals and permits accounted for Board submission fees, expediter costs, DOB filing fees, and inspection costs are either included or explicitly excluded with an estimate provided
Warning sign Permitting, expediting, and board costs not mentioned; client later discovers these are separate — often adding $15,000–$40,000 in New York City
Building constraints addressed Electrical capacity, plumbing stack limitations, HVAC feasibility, and work-hour restrictions assessed before pricing is finalized
Warning sign Estimate produced without a site visit or building review; structural and mechanical assumptions left as unknowns that become change orders later
Policy stated upfront Written change-order process described in the contract: documentation requirements, pricing method, approval steps before any additional work proceeds
Warning sign No change-order policy in the contract; verbal approvals accepted; costs and schedule impact not documented in writing
